Fiberglass Pool Installation Timeline: What to Expect in Florida
Complete timeline for fiberglass pool installation in Florida. From permits to first swim, understand each step of the process and how weather affects your project.

Your Florida Pool Installation Journey
Installing a fiberglass pool in Florida is an exciting project that transforms your backyard into a personal paradise. Understanding the timeline helps you plan accordingly and sets realistic expectations. While concrete pools take 3-6 months, fiberglass installations typically complete in 2-4 weeks—perfect for Florida homeowners eager to start swimming.
Pre-Installation Phase (2-4 Weeks)
Week 1-2: Planning and Permitting
Your pool builder submits permit applications to your county building department. Florida permits typically require site plans showing pool location, setbacks from property lines, barrier fencing details, and electrical plans. Most counties process permits within 7-14 business days, though complex sites may take longer.
During this time, finalize your pool design, color selection, and any additional features like LED lighting, water features, or attached spas. Mark underground utilities through Florida's Sunshine 811 service—a free, required step preventing costly damage to water, gas, or electrical lines.
Week 2-4: Pool Ordering and Preparation
Once permits are approved, your builder orders your fiberglass pool shell from the manufacturer. Production typically takes 2-3 weeks. Meanwhile, schedule any necessary site preparation: tree removal, grading, or access improvements for delivery trucks.
Your builder also orders ancillary equipment: pumps, filters, heaters, and plumbing supplies. Everything arrives coordinated for a smooth installation process.
Installation Phase (1-2 Weeks)
Day 1-2: Excavation
The most dramatic phase begins with excavation. Heavy equipment digs a hole slightly larger than your pool shell, accounting for backfill material and plumbing access. In Florida, excavation reveals our sandy soil—generally excellent for pool installation due to superior drainage.
Excavators remove 20-30 cubic yards of soil, which can be used for landscaping or hauled away. The hole includes space for equipment pads and plumbing trenches extending to your equipment location.

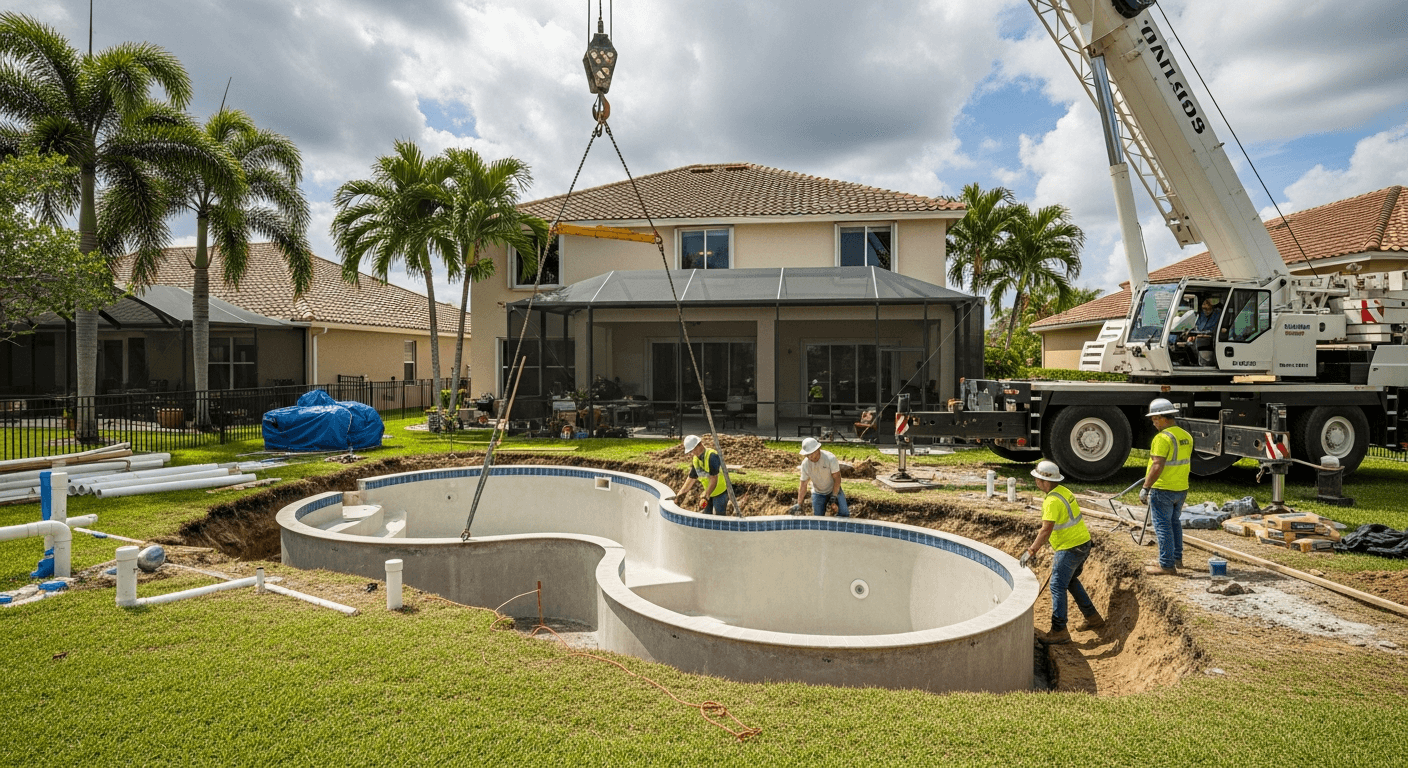

Day 3: Pool Delivery and Set
The fiberglass shell arrives on a specialized truck, often requiring temporary driveway or lawn protection. A crane carefully lifts the shell (weighing 5,000-8,000 pounds when empty) and lowers it into the excavated hole.
Technicians level the pool precisely—critical for proper operation and aesthetics. They adjust the shell position, checking measurements from all angles. Once perfectly positioned, they begin backfilling around the shell for stability.
Day 4-5: Plumbing and Electrical
Licensed plumbers install main drains, return lines, skimmers, and all internal plumbing. They connect the pool to the equipment pad where your pump, filter, and heater will reside. Pressure testing ensures all connections are watertight—essential in Florida where water tables are high.
Electricians run power to the equipment pad and install pool lights, following Florida's strict electrical codes. All electrical work requires inspection before covering. GFCI protection on all pool circuits ensures safety.
Day 6-8: Backfilling and Deck Preparation
Simultaneous with plumbing work, crews backfill around the pool shell using sand or gravel. They compact material in layers, ensuring uniform support around the entire shell. This prevents shifting or settling—particularly important during Florida's rainy season.
As backfilling progresses, crews grade the pool perimeter for deck installation. Proper drainage away from the pool prevents deck flooding and erosion. In Florida, we must account for heavy rainfall, designing drainage that handles 6-8 inches of rain during summer storms.
Day 9-12: Decking Installation
Deck installation method varies by material choice:
- Concrete/Pavers: Forms are set, concrete poured, and finished or pavers laid on a sand/gravel base. Stamped or textured concrete takes 2-3 days; pavers install in 1-2 days.
- Travertine/Natural Stone: Premium materials require careful laying and sealing. Expect 2-4 days for professional installation.
- Cool Deck Coatings: Applied over concrete, these coatings cure in 24-48 hours, staying comfortable under Florida sun.
Florida building codes require slip-resistant surfaces within 4 feet of pool edges. Quality contractors ensure compliance while creating attractive, functional spaces.
Final Phase (3-7 Days)
Equipment Installation and Startup
Technicians install and connect all equipment: pumps, filters, heaters, automation systems, and sanitizers. They fill the pool—typically taking 12-24 hours depending on water pressure. Many Florida homeowners use well water or pool water delivery services for faster filling.
Once full, technicians balance water chemistry, start circulation, and verify all systems function correctly. They program automation, set timers, and ensure LED lighting operates as designed.
Fence and Barrier Installation
Florida law requires barrier fencing before the pool can be used. Professional fence installers complete this work in 1-2 days, coordinating with your overall project timeline. Self-closing, self-latching gates meet safety codes and pass inspection.
Final Inspection
County inspectors verify electrical, plumbing, and barrier compliance. Most Florida installations pass initial inspection when work is performed by licensed contractors following code. Any required corrections are addressed immediately, ensuring legal operation.
Weather Impact on Timeline
Florida weather significantly affects installation schedules:
Rainy Season (June-September): Afternoon thunderstorms may cause daily delays but rarely extend projects more than 2-3 days total. Experienced builders schedule concrete work for morning hours before typical rain.
Hurricane Season: Tropical systems can delay projects several days to weeks depending on severity. Most builders pause work when storms approach, resuming once conditions clear.
Dry Season (October-May): Optimal construction weather allows uninterrupted work. Many Florida homeowners schedule installations during these months for predictable timelines.
First Swim Preparation
After final inspection approval, your pool is swim-ready! However, give new concrete decks 7 days to cure before heavy use. Fiberglass shells are immediately swimmable once chemistry is balanced.
Your builder provides comprehensive operation training: equipment functions, basic maintenance, chemical testing, and troubleshooting. Quality builders offer ongoing support as you become familiar with your new pool.
Realistic Expectations
Typical Florida fiberglass pool installations complete in 2-4 weeks from permit approval to first swim. Factors affecting timeline include:
- Permit processing speed (varies by county)
- Pool shell manufacturing and delivery
- Weather conditions during construction
- Complexity of deck and landscaping
- Availability of inspectors
While delays occasionally occur, fiberglass pools install dramatically faster than concrete alternatives. Most Florida families are swimming within a month of breaking ground—transforming their backyard and lifestyle in record time.
Work with experienced Florida pool builders who understand local codes, weather patterns, and best practices. Their expertise ensures smooth installations that meet timeline expectations while delivering the quality pool you deserve.
